Uncertainty Quantification

MADS is applied to perform uncertainty quantification using Bayesian sampling.

The analyses below are performed using examples/bayesian_sampling/bayesian_sampling.jl.

Model setup

There are:

  • Contaminant source (yellow rectangle)
  • 3 monitoring wells (W1, W2, and W3; blue dots)

Prior spaghetti plots

Below we show joint and individual spaghetti plots of 100 model runs representing the prior model prediction uncertainties at the 3 monitoring wells.

Joint spaghetti plots

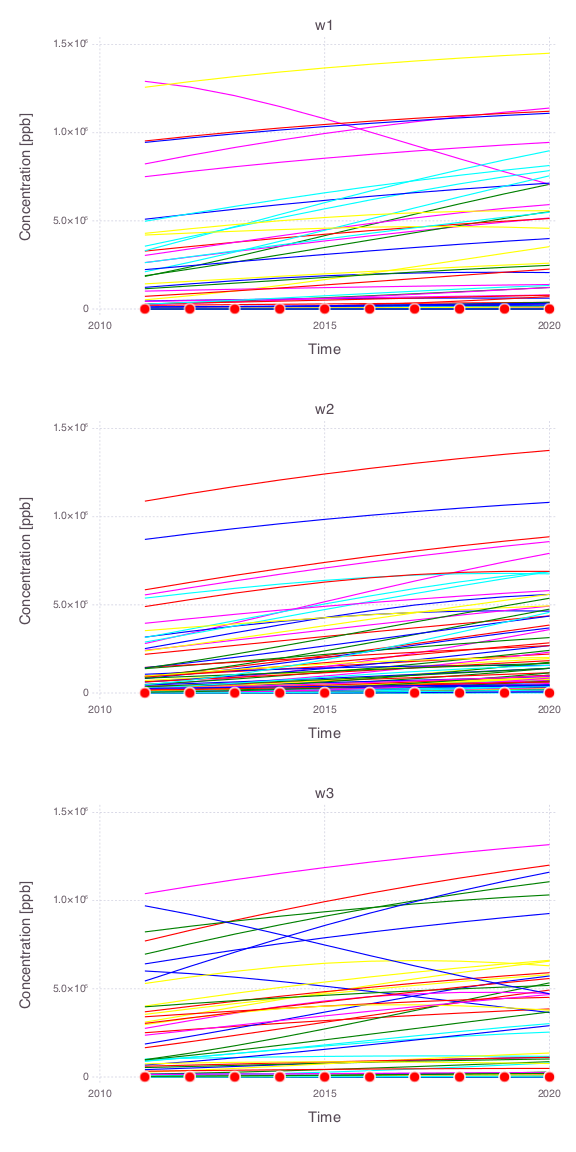

All model parameters are changed simultaneously within their prior uncertainty ranges.

Individual spaghetti plots

A single model parameter is changed at a time.

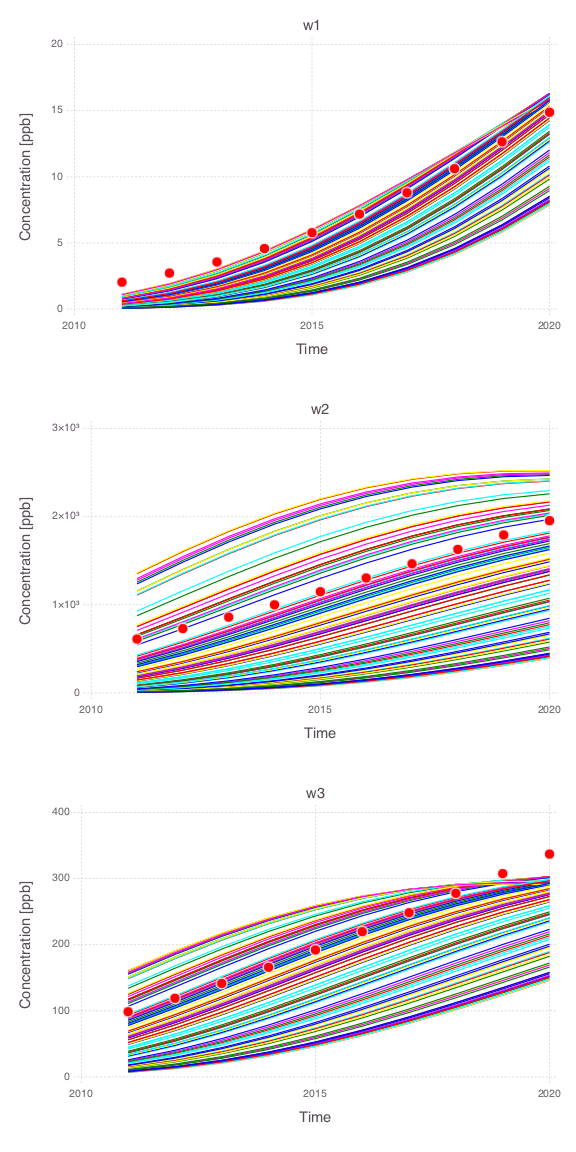

  • Source $x$ location

  • Source $y$ location

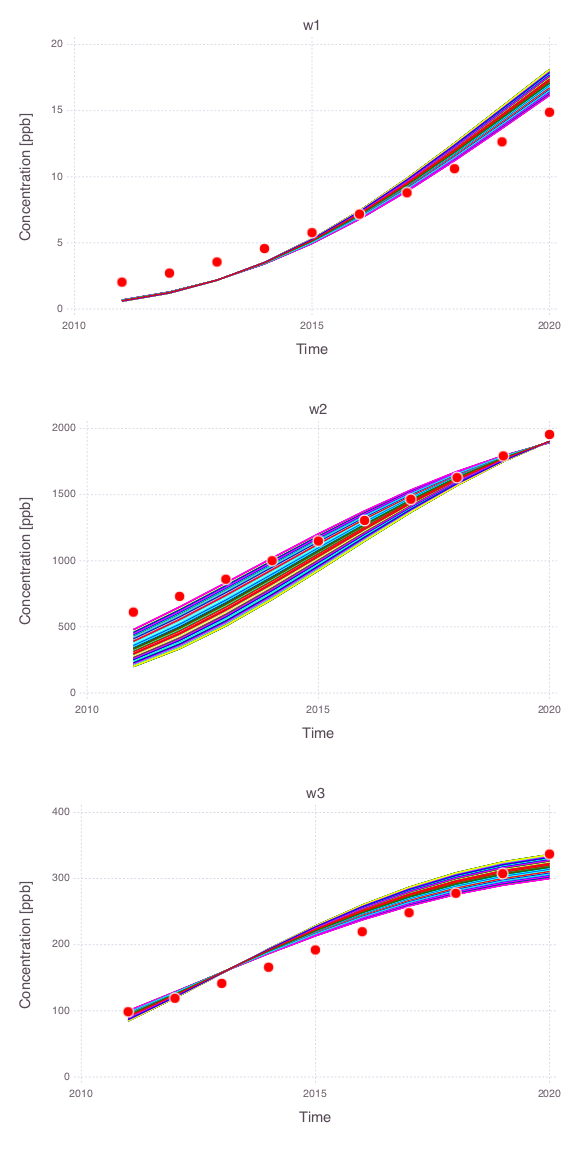

  • Source size along $x$ axis

  • Source size along $y$ axis

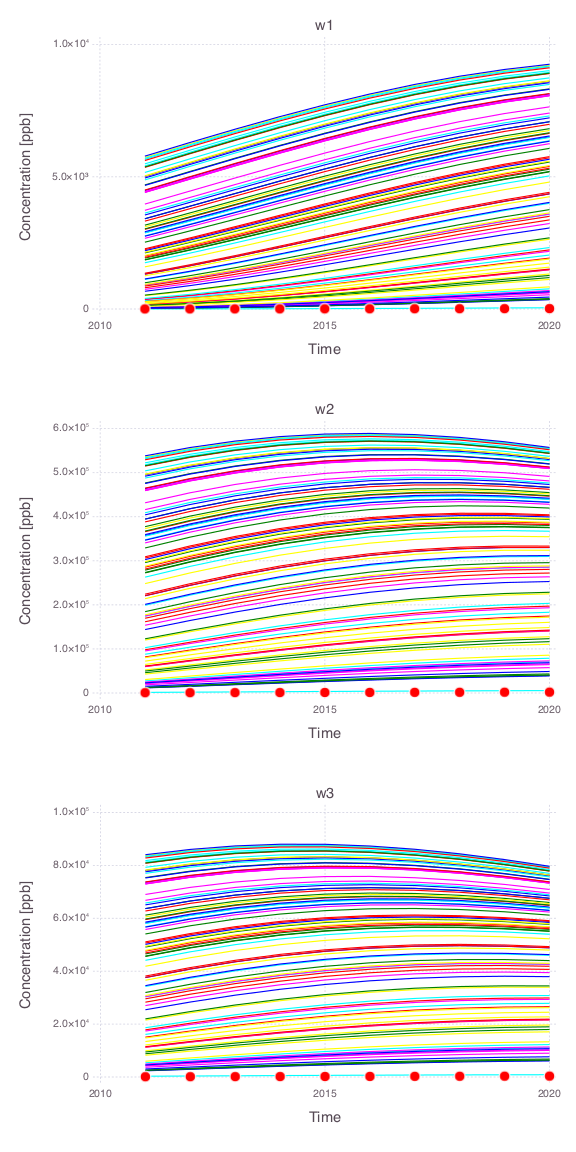

  • Source release time $t_0$

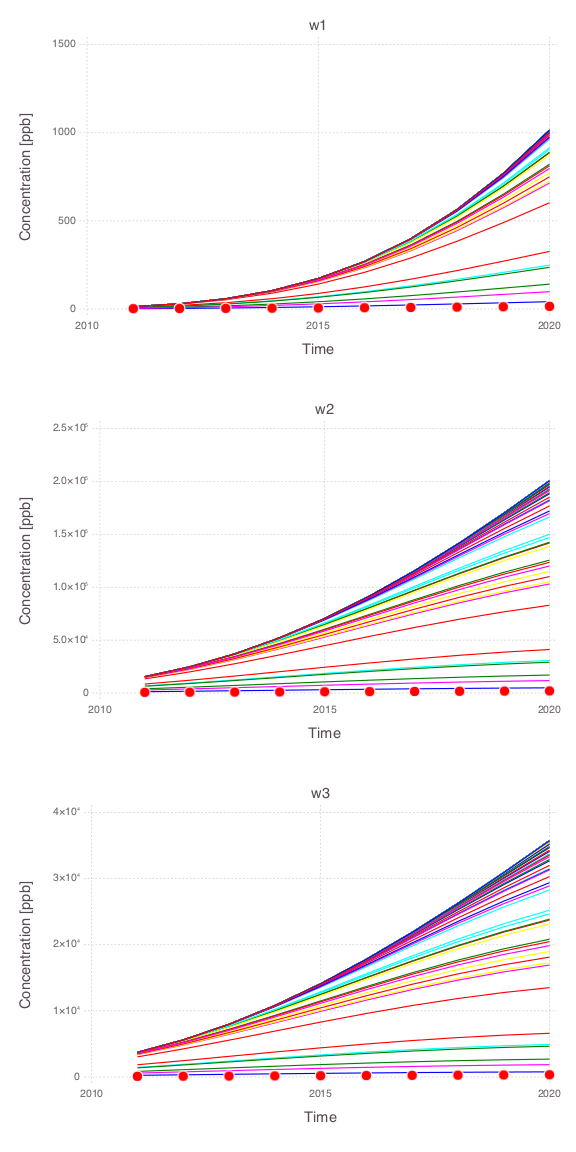

  • Source termination time $t_1$

Model calibration match

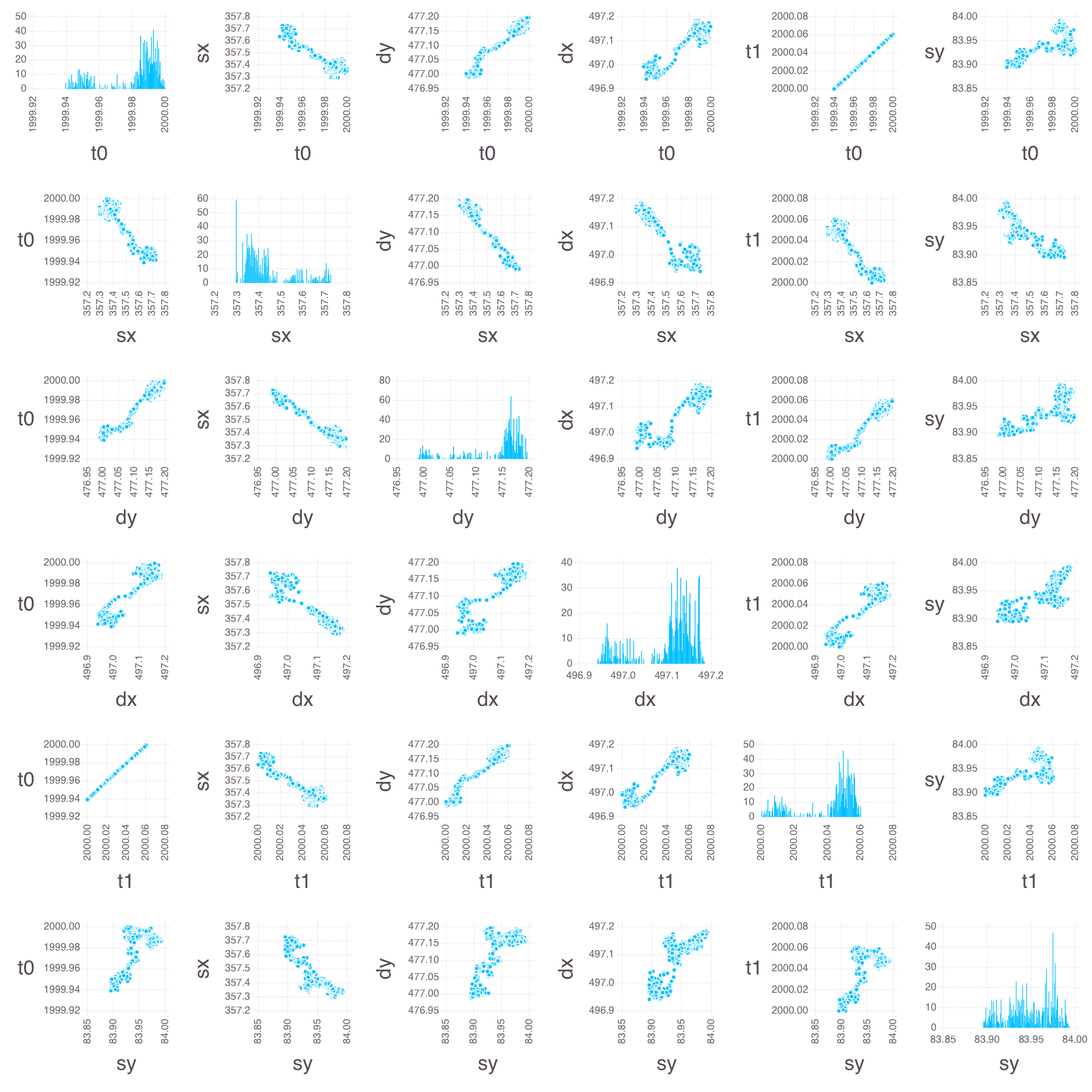

Bayesian sampling results

Posterior spaghetti plots

Spaghetti plots of 1000 model predictions representing the posterior model uncertainties at the 3 monitoring wells.

Joint spaghetti plots

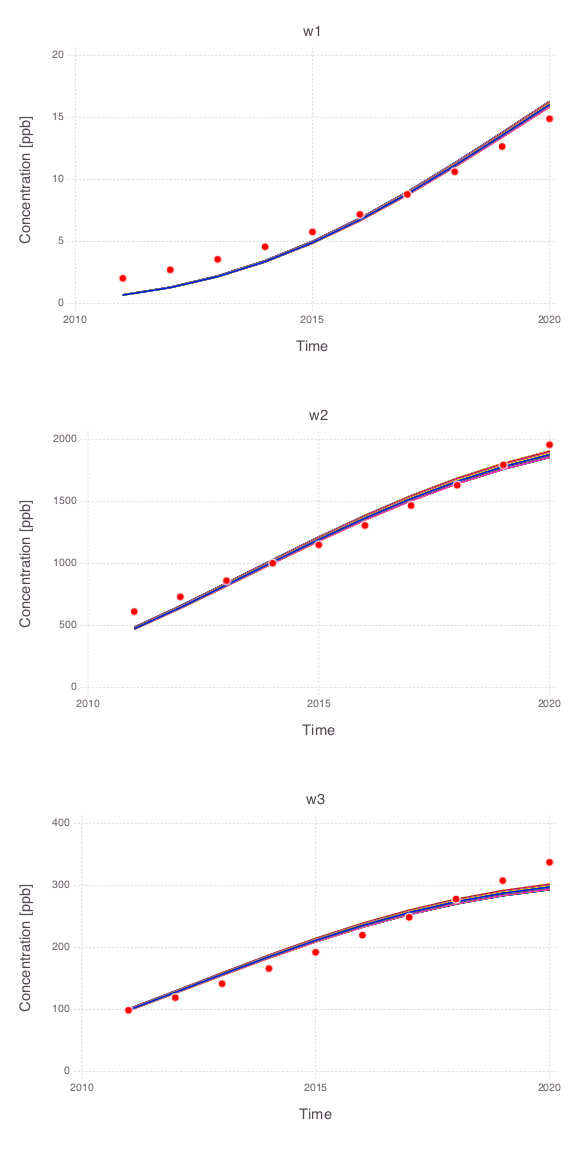

All model parameters are changed simultaneously within their prior uncertainty ranges.

Individual spaghetti plots

A single model parameter is changed at a time.

Note that only the posterior uncertainties in the source release time ($t_0$) and the source termination time ($t_1$) are producing large impact in the model predictions.

  • Source $x$ location (all the 1000 model predictions are overlapping)

  • Source $y$ location (all the 1000 model predictions are overlapping)

  • Source size along $x$ axis (all the 1000 model predictions are overlapping)

  • Source size along $y$ axis (all the 1000 model predictions are overlapping)

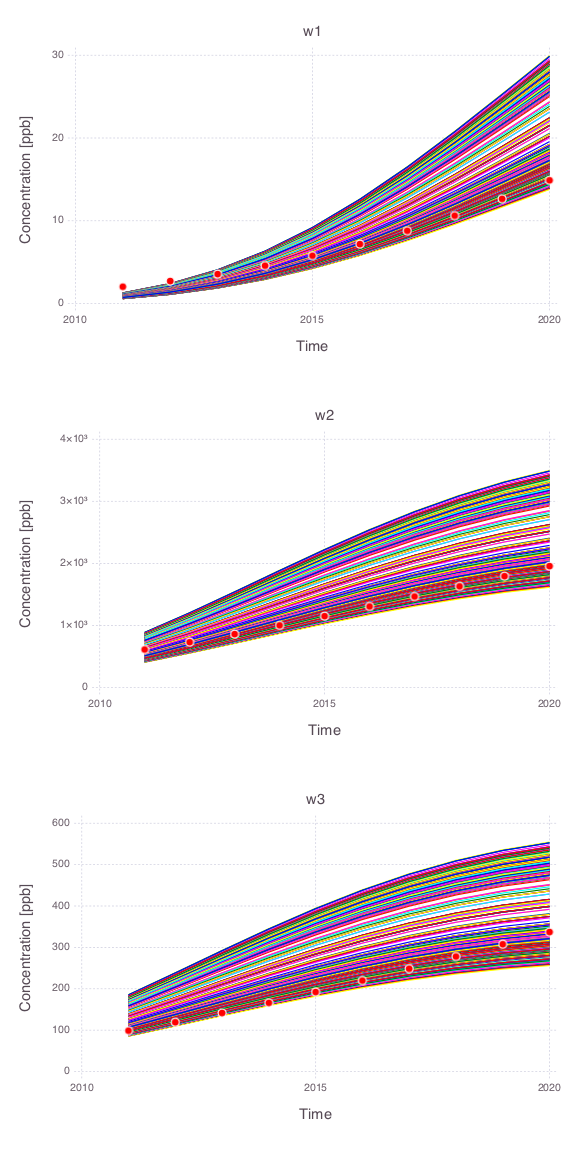

  • Source release time $t_0$

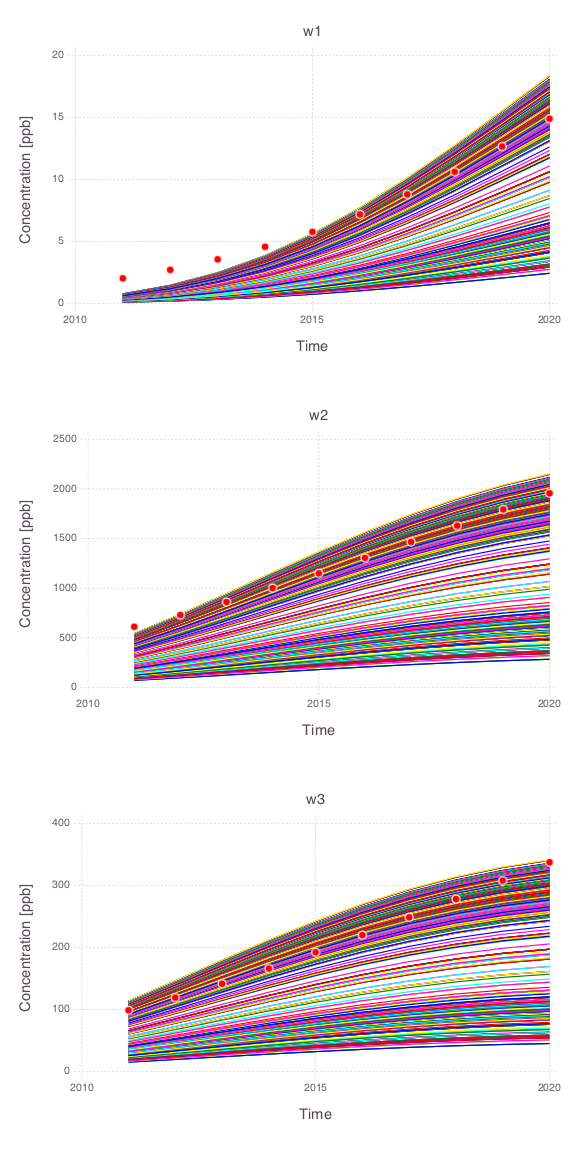

  • Source termination time $t_1$
